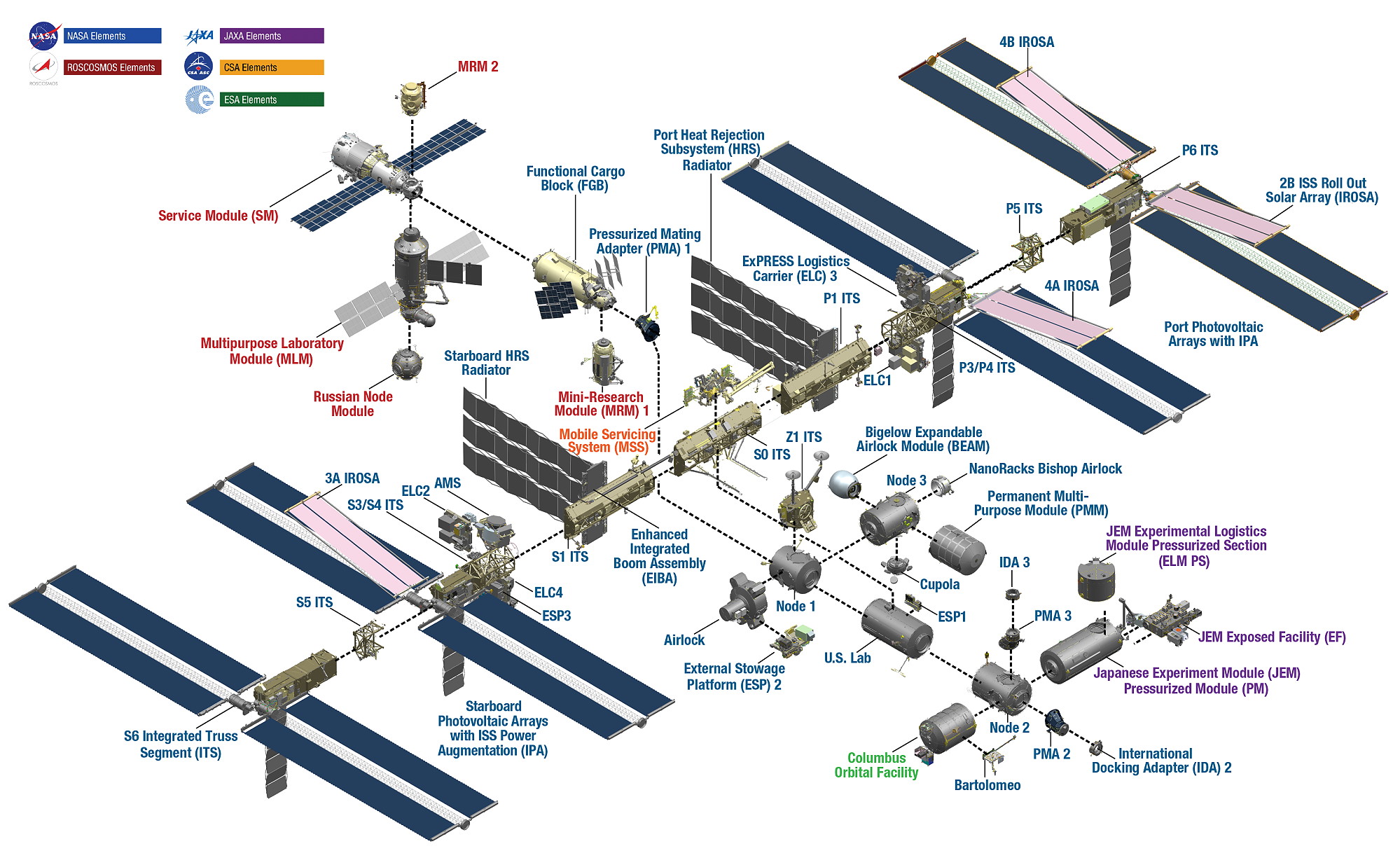

20.11.1998 Launch of the Zarya Control Module with a Proton
rocket. |
|
|
|
04.12. - 15.12.1998 The crew of
STS-88 docks the
Unity node to the
ISS. |
|
|
|
27.05. - 06.06.1999 Nearly 2 tons of equipment were brought to
the
ISS and the Canadian built manipulator arm were mount
by the crew of STS-96. |
|
|
|
19.05. - 29.05.2000 The crew of
STS-101 installed
the final parts of the Russian built crane. |
|
|
|
12.07.2000 The Zvezda Service Module launched atop a Russian
Proton rocket and docked to the Station two weeks later. |
|
|
|
08.09. - 20.09.2000 STS-106 completed final connections (electrical-, data- and
television cables) between Zvezda module and component Zarya. |
|
|
|
11.- 24.10.2000 The crew of
STS-92 attached the
docking port, called Pressurized Mating Adapter 3 (PMA-3). |
|
Expedition 1 |
|
01.- 11.12.2000 Attaching of the P6 solar array structure by
the crew of STS-97. |
|
|
07. - 20.02.2001 The crew of
STS-98 docked the
Destiny lab. |
|
Expedition 2 |
|
08. - 21.03.2001 STS-102:
PMA-3 repositioned from the berth to the port side of
Unity to make room for Italian built Multi-Purpose Logistics Module
"Leonardo". |
|
|
19.04. - 01.05.2001 Installing of the Canadian built robotic
arm (57.7 foot long) called Canadarm2 by the crew of
STS-100. |
|
|
12. - 25.07.2001 The crew of
STS-104 attached
Joint Airlock Module ("Quest"). |
|
Expedition 3 |
|
10. - 22.08.2001 Ammonia servicing unit and two science
experiment packages attached by the
STS-105
crew. |
|
Expedition 4 |
|
05. - 17.12.2001 STS-108 brought three tons of supplies with the
MPLM Raffaello cargo module. |
|
|
08. - 19.04.2002 Integrated Truss Structure S0 and Mobile
Transporter attached by the crew of
STS-110. |
|
Expedition 5 |
|
05. - 19.06.2002 Installation of the second component of
Canada's Remote Servicing System to the
ISS (STS-111). |
|
|
07. - 18.10.2002 The crew of
STS-112 attached the
Star-board One (S1) Truss and the first (S0) Truss segment. |
|
Expedition 6 |
|
24.11. - 07.12.2002 P1 solar array truss segment attached by
the crew of STS-113. |
|
Expedition 7 |
|
|
|
Expedition 8 |
|
|
|
Expedition 9 |
|
|
|
Expedition 10 |
|
|
|
Expedition 11 |
|
26.07. - 09.08.2005 Installation of the External Stowage
Platform-2 Attachment Device (STS-114). |
|
Expedition 12 |
|
|
|
Expedition 13 |
|
04. - 17.07.2006 The crew of
STS-121 brought
supplies with the
MPLM cargo module. |
|
|
09. - 21.09.2006 The crew of
STS-115 installed
the P3/P4 integrated truss and the solar arrays. |
|
Expedition 14 |
|
10. - 22.12.2006 P5 truss segment attached (STS-116). |
|
Expedition 15 |
|
08. - 22.06.2007 Installation of the S3/S4 truss by the crew
of STS-117. |
|
|
08. - 21.08.2007 S5 truss attached (STS-118). |
|
Expedition 16 |
|
23.10. - 07.11.2007 The crew of
STS-120 attached the
Node 2 ("Harmony"). |
|
|
07. - 20.02.2008 European Columbus module attached by the crew
of STS-122. |
|
|
11. - 27.03.2008 The crew of
STS-123 attached the
Japanese Experiment Module ("Kibo") and the Canadian built Special Purpose
Dexterous Manipulator ("Dextre"). |
|
|
03.04.2008 Arrival of the
ESA
built Automated Transfer Vehicle (ATV) |
|
Expedition 17 |
|
31.05. - 14.06.2008 The
JEM PM and the
JEM RMS was attached by the crew of
STS-124. |
|
Expedition 18 |
|
15. - 30.11.2008 The crew of
STS-126 brought with
MPLM Leonardo supplies and equipment to the
ISS. |
|
|
15. - 28.03.2009 ITS-S6 attached by the crew of
STS-119. |
|
Expedition 19 |
|
|
|
Expedition 20 |
|
15. - 31.07.2009 The
JEM EF,
JEM ELM-ES was attached by the crew of
STS-127. |
|
|
29.08. - 12.09.2009 The crew of
STS-128 brought with
MPLM Leonardo supplies and equipment to the
ISS. |
|
|
17.09.2009 Arrival of the
JAXA built
HTV |
|
Expedition 21 |
|
16. - 27.11.2009 ELC-1
ELC-2 attached by the crew of
STS-129. |
|
Expedition 22 |
|
08. - 22.02.2010 The crew of
STS-130 attached the
Tranquility node and the Cupola. |
|
Expedition 23 |
|
05. - 20.04.2010 The crew of
STS-131 brought with
MPLM Leonardo supplies and equipment to the
ISS. |
|
|
14. - 26.05.2010 ICC,
MRM-1 (now Rassvet),
ERA
attached by the crew of STS-132. |
|
Expedition 24 |
|
|
|
Expedition 25 |
|
|
|
Expedition 26 |
|
24.02. - 09.03.2011 ELC-4 and PMM attached by the crew of
STS-133. |
|
Expedition 27 |
|
16.05. - 01.06.2011 ELC-3 and
AMS attached by the crew of
STS-134. |
|
Expedition 28 |
|
08. - 21.07.2011 The crew of
STS-135 brought with
MPLM Raffaello supplies and equipment to the
ISS. |
|
Expedition 29 |
|
|
|
Expedition 30 |
|
|
|
Expedition 31 |
|
|
|
Expedition 32 |
|
|
|
Expedition 33 |
|
|
|
Expedition 34 |
|
|
|
Expedition 35 |
|
|
|
Expedition 36 |
|
|
|
Expedition 37 |
|
|
|
Expedition 38 |
|
|
|
Expedition 39 |
|
|
|
Expedition 40 |
|
|
|
Expedition 41 |
|
|
|
Expedition 42 |
|
|
|
Expedition 43 |
|
|
|
Expedition 44 |
|
|
|
Expedition 45 |
|
|
|
Expedition 46 |
|
|
|
Expedition 47 |
|
Dragon SpX-8 or CRS-8 brought the module BEAM to the
ISS |
|
Expedition 48 |
|
Dragon SpX-9 or CRS-9 brought docking adapter IDA-2 to the
ISS |
|
Expedition 49 |
|
|
|
Expedition 50 |
|
|
|
Expedition 51 |
|
|
|
Expedition 52 |
|
|
|
Expedition 53 |
|
|
|
Expedition 54 |
|
|
|
Expedition 55 |
|
|
|
Expedition 56 |
|
|
|
Expedition 57 |
|
|
|
Expedition 58 |
|
|
|
Expedition 59 |
|
|
|
Expedition 60 |
|
Dragon SpX-18 or CRS-18 brought docking adapter IDA-3 to the
ISS |
|
Expedition 61 |
|
|
|
Expedition 62 |
|
|
|
Expedition 63 |
|
|
|
Expedition 64 |
|
Dragon SpX-21 or CRS-21 brought the Bishop Airlock to the
ISS |
|
Expedition 65 |
|
Russian science module Nauka docked to ISS
Dragon SpX-22 or CRS-22 brought iROSA panel 2B und 4B to the
ISS |
|
Expedition 66 |
|
Russian docking module Prichal docked to ISS |
|
Expedition 67 |
|
|
|
Expedition 68 |
|
Dragon SpX-26 or CRS-26 brought iROSA panel 3A und 4A to the
ISS |
|
Expedition 69 |
|
|
|
Expedition 70 |
|
|
|
Expedition 71 |
|
|
|
Expedition 72 |
|
|
|
